Thu, Dec 5 @ 4pm: The Fitness Floor at the Recreation Center is reopening in a temporary new location while we continue repairs to the main fitness area.  Learn more.

Recreation Center of
Highland Park Renovation
Project End Date
September 2017
Location
1207 Park Ave. West
Project Team
Woodhouse Tinucci Architects (architecture), Enspect Engineering (structural), Anna Morton Engineering (MEP/EP)
Budget
$900,000

Project Overview

Renovation of the Recreation Center of Highland Park is a Phase 1 project identified in
 the GreenPrint 2024 Master Plan.  The project includes relocation of the Group Exercise studio to the lower level, creation of  a new training studio for both personal and small group fitness training, reconfiguration the fitness desk and lobby area, and expansion of the fitness floor square footage.  The facility will remain open during construction with limited disruption to patrons.

The top priority identified in the Recreation Center of Highland Park annual fitness member survey for the past three years is the need for more space on the fitness floor as well as dedicated space for stretching.  You spoke and we listened.

The renovation of the lower level will take place Mar-Apr 2017 and will include…

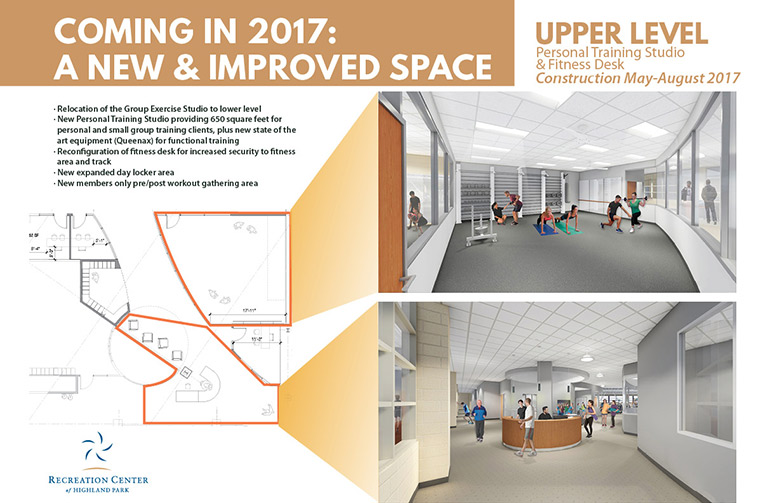

The renovation of the upper level will take place May-August 2017 and will include…

Schedule

Updated 5/17

DatesDescription
October-November 2016Design Development
November-December 2016Construction Documents
January-February 2017Bidding & Negotiation
March-June 2017Lower Level Construction
April-August 2017Upper Level Construction
September 2017Estimated Grand Opening

Updates

July 26, 2017

Renovation Final Phase

The renovation project is wrapping up in August and will require a number of facility schedule changes from Aug 21 – Sept 5.

July 26, 2017
August 21-25, 2017

Full Facility Closure

Entire building will be closed to public

Limited schedule of group exercise classes will be offered at various Park District Locations

August 21-25, 2017
August 26-31, 2017

Partial Facility Closure

Gymnasiums and Group Exercise Studios will be open

Fitness Center, Kid Fit, indoor pool and Track remain closed

August 26-31, 2017
September 1-5, 2017

Fitness Center, Kid Fit and Track re-opens Fri., Sept 1

Indoor pool remains closed until Tues, Sept 5

Thank you in advance for your patience as we finalize this exciting project for the community.  Please call 847.579.4554 for additional project updates.

September 1-5, 2017
July 11, 2017

This is Timeline description, you can change All group exercise classes have now been moved to the new lower level studio accommodating larger class sizes, a new variety of class options and expanded personal training opportunities.

This week, work on the Phase 2 –  upper level included removal of the temporary wall which wrapped around newly constructed offices. Overnight on June 26, demolition of the old group exercise studio was completed.

July 11, 2017
June 27, 2017

New state-of-the-art Group Exercise Studio opened for regular classes on Tuesday, June 27.  A special open house was held on Monday, June 26 for members to try out the new space.

Phase 2 of the renovation also went into full swing on Tuesday. Upstairs demolition will take place at night throughout the week. Additional temporary walls will be erected to minimize disruption to members.

June 27, 2017
May 4, 2017

The lower level construction is progressing with:
– Installation of the structural steel for room partition

– Installation of the new window on the east wall

– Installation of drywall on the north and south walls, center partition and new storage closet

– Installation of new ceiling ventilation

Remaining work for Phase 1 includes installation of the new Queenax Fitness Equipment, new bamboo floor, acoustical ceiling tiles, lighting, sound system and painting.

 Boller Construction began Phase 2 construction of the upper level on Monday, April 17.

Boller Construction began Phase 2 construction of the upper level on Monday, April 17.
– A temporary construction wall was built behind the fitness desk which wraps around the current offices, storage closet, member day lockers, trainer’s office and a portion of KidFit
– Temporary lockers and coat hooks have been placed adjacent to the fitness desk to accommodate members during renovation
– Overnight demolition of current walls and trash disposal was completed after business hours to avoid disturbance to members
– Drywall Framing is complete for new member retreat area, day lockers and offices
– Ongoing work including rerouting electrical and data lines

New rooftop HVAC units will be installed over the next few weeks which will significantly improve heating, cooling and ventilation of the fitness floor, spin and yoga studios and new group exercise studio.  The project team anticipates that the project will be completed approximately 1-2 weeks later than previously scheduled, but still within the advertised timeframe of Early Fall, 2017.

May 4, 2017
April 13, 2017

Only one month into our renovation project and construction crews are making significant progress on the new lower level Main Group Exercise Studio.

On Monday, April 17 construction begins on the upper level!

How will this impact members?
Limited Lockers – are temporarily relocated by the upper level reception desk.  Additional lockers are available in the lower level locker room.

Temporary Walls – have been erected to minimize disruption to members during construction

Personal Training – office and stretching table are temporarily relocated to the lower level

The Recreation Center remains open during construction.  Once completed, the upper level will feature:
– Expansion of the fitness floor by 850 square feet
– A new dedicated stretching area
– Expanded free weight area
– A new 650 square foot personal training studio
– Enhanced Members Entrance and Retreat Area

April 13, 2017
March 9, 2017

 Construction began on Wednesday, March 8 on the new lower level Group Exercise Studio. Once completed, the new studio will be approximately 500 square feet larger that the current studio and will feature:

– A free floating bamboo floor with spring installation for maximum impact absorption
– State-of-the art Queenax equipment
– Improved lighting including brighter LED fixtures as well as additional windows providing more natural light and scenic views of the wetlands west of the Recreation Center

The Recreation Center remains open during construction.

March 9, 2017
February 23, 2017

Design development, construction documents and the bidding process were completed on  schedule.  The Park Board approved staff to enter into a contractual agreement with Boller Construction for the project at the February 21 meeting.  The anticipated start date is early March 2017.

February 23, 2017
